During the week of October 6, the Gowanus Remediation Team (GRT) continued RTA 2 Bulkhead Support System installation operations.

Bulkhead installation continued near 9th Street. Grout was placed. Bearing plates were sealed. Sheet piles were installed and cut to grade. Drain outlets were installed. Site restoration began.

Bulkhead installation continued near 3rd Street. Tiebacks were installed. Grout was placed.

Bulkhead installation continued near Bush Street. Tiebacks were installed. Grout was placed.

Bulkhead installation continued at the 6th Street Turning Basin. Tiebacks were installed.

Bulkhead installation continued near Bond Street. Sheet piles were installed.

Bulkhead installation began near 6th Street. Sheet piles were installed.

Photos of construction activities are provided below.

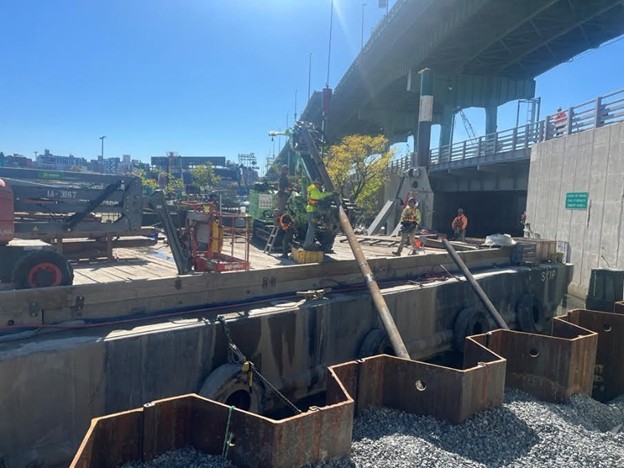

Sheet pile installation at the 6th Street Turning Basin.
Tieback installation near 9th street.
